Skip to main content

Data Warehouse

Four pages covering DWA — the metadata-driven service that loads the integrated data model from the files in the lake. This is the heart of the platform, and where most operator intervention happens.


Loading Tasks​

The main warehouse monitor: did every load step complete for every sourcefile?

The task grid is scoped to the sidebar date range. The Failed tasks and Tasks still in progress sections are deliberately not — they always read the latest execution, so an active problem cannot be hidden by a narrow window.

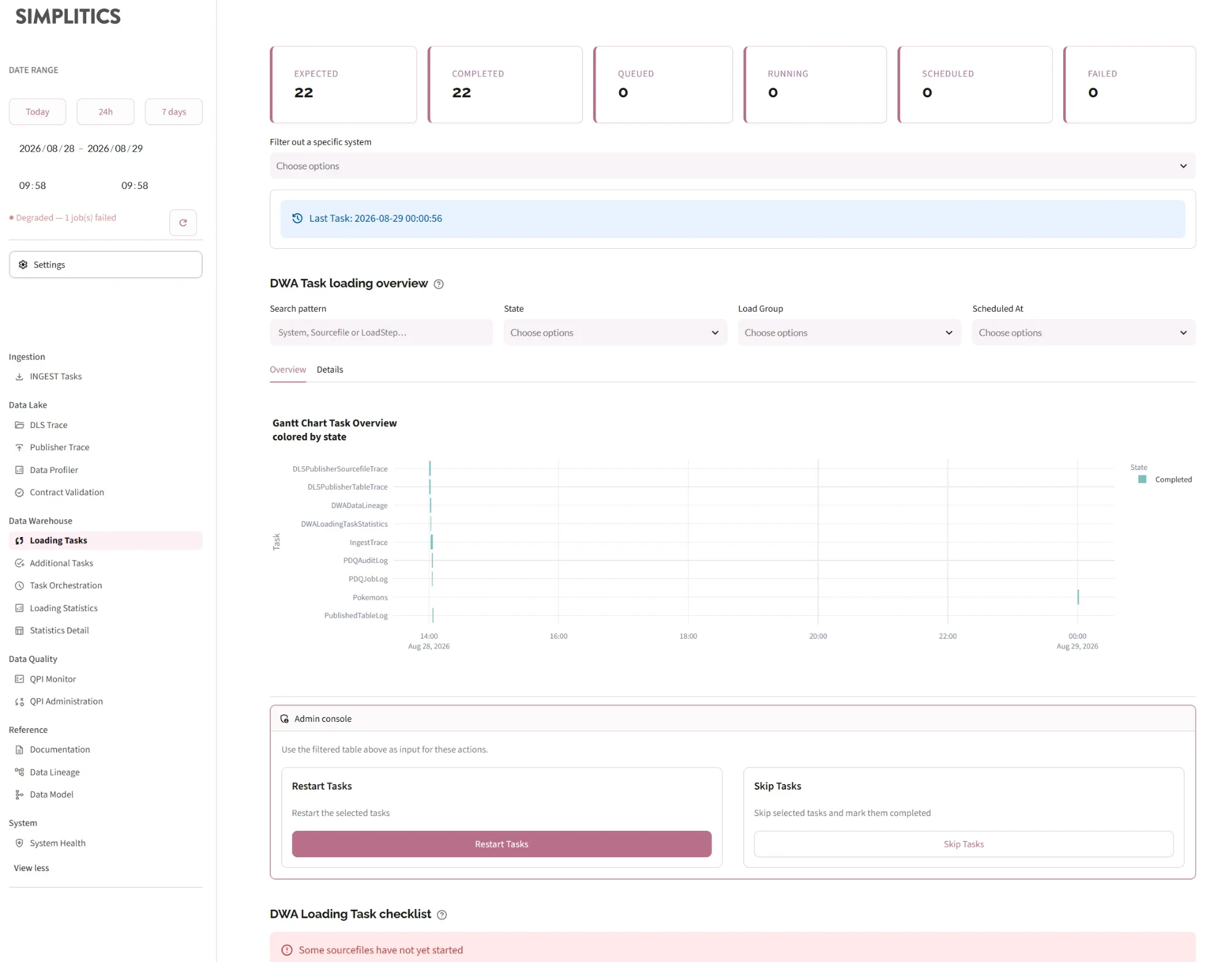

Loading Tasks: the state metrics, the DWA task loading overview with its Gantt chart, and the admin console

State metrics and system filter​

The standard counter row — Expected, Completed, Queued, Running, Scheduled, Failed — followed by a single-system filter, and a Last Task panel showing the most recent start time in the window.

The DWA loading state metrics: Expected, Completed, Queued, Running, Scheduled and Failed

Failed tasks​

Failures are grouped by extracted error text, not listed individually. The console pulls the core exception out of each error message, groups on it, and renders one expander per distinct cause showing the affected Sourcefile / ExecutionDateTime / LoadStep rows and the full error.

Two bulk actions apply to all listed failures, behind an explicit confirmation:

ActionWhat it does
RestartPer sourcefile. The API discovers the active run and re-schedules every step not yet Completed.
SkipPer step, matched on Sourcefile + ExecutionDateTime + LoadStep. Marks each Completed without running it.
Restart is safe

DWA loading tasks are idempotent — rerunning one cannot duplicate or corrupt data. Restarting a failed load is the standard first move, not a last resort. Skip is the exception: it declares work done that never ran, so use it only when you know the data is not needed.

Tasks still in progress​

A coloured bar chart of incomplete work by sourcefile and state, then a selectable table. Filter by state, select the rows you want, choose Restart or Skip, and confirm. Unlike the Failed section this acts on your selection only.

DWA Task loading overview​

Fast filters — search (System, Sourcefile or LoadStep), State, Load Group, Scheduled At — feeding two tabs:

  • Overview — a Gantt chart of every step, when it ran and how long it took
  • Details — the same rows as a table, with millisecond execution timestamps

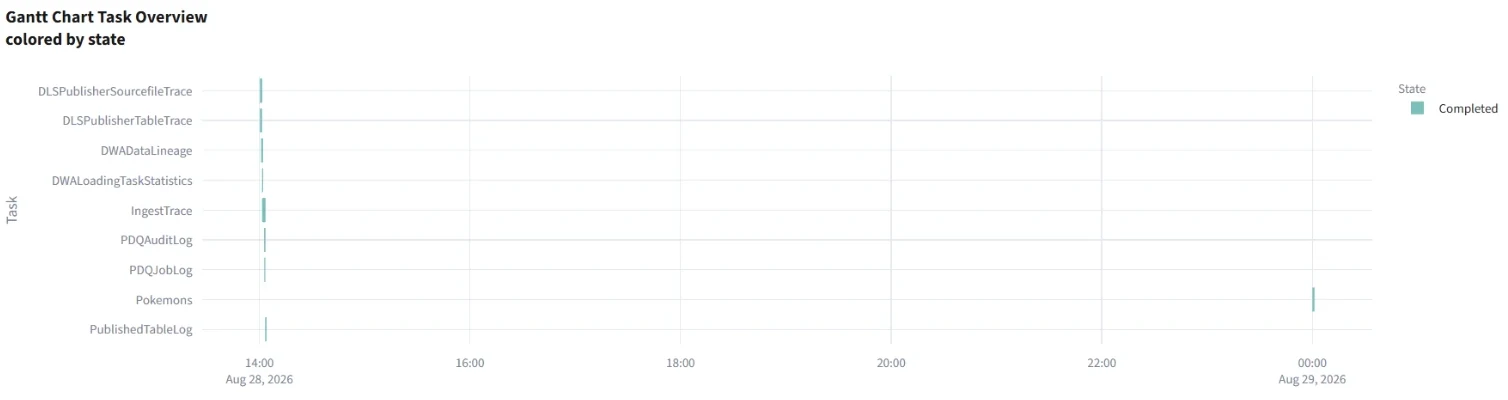

The Gantt chart task overview, one row per task, coloured by state

Admin console​

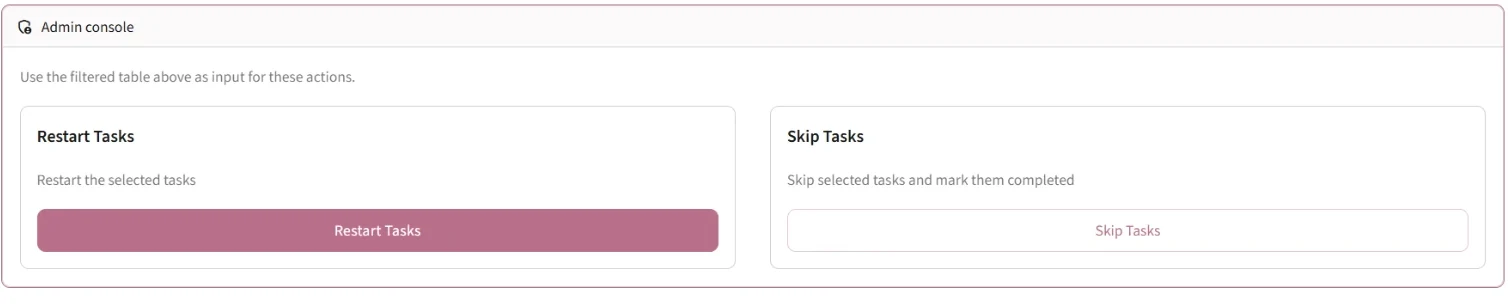

Admin only. Restart Tasks or Skip Tasks applied to everything in the filtered view. Both audit-logged.

The Loading Tasks admin console, with Restart Tasks and Skip Tasks acting on the filtered table above

DWA Loading Task checklist​

Every scheduled sourcefile against what actually started. Columns: sourcefile, a readable schedule ("Every 2 hours", "On event-basis"), executed flag, still-in-progress flag, last execution, next scheduled execution. Rows that never started are highlighted, and the expander opens automatically when any are found.


Additional Tasks​

Post-processors — extra processing that can be hooked onto the standard loading flows. Same shape as the loading page, with the dependency structure made explicit.

  • Time Window / Last Task — the span from first start to last finish. A span over 25 hours is flagged red as lagging.
  • State metrics — the standard counter row
  • Filter by source system — narrows the chart and checklist by processor type

Two tabs: a Timeline (Gantt) with zoom presets (1d, 1w, 1m, 6m, YTD, 1y, all, defaulting to today), and a Task Detail table with a filter builder.

Incomplete workloads​

Read from a dedicated status endpoint, so it covers every outstanding task regardless of the record limit above. An overview bar chart by state, a details pane with per-processor restart buttons, and a full incomplete-task table.

Checklist and dependency graph​

The checklist lists every configured post-processor, its dependencies and its run command, with an executed flag. Selecting a row reveals the full run command as SQL.

Below it, a left-to-right dependency graph: arrows show execution order, a processor runs once its dependencies have. Nodes are coloured by whether they are a processor in their own right or an external dependency, and rank is derived from the dependency chain — so a processor another processor waits on sits to its left.


Task Orchestration​

The schedule editor. Where the other DWA pages show what ran, this shows what is meant to run, and lets an admin change it.

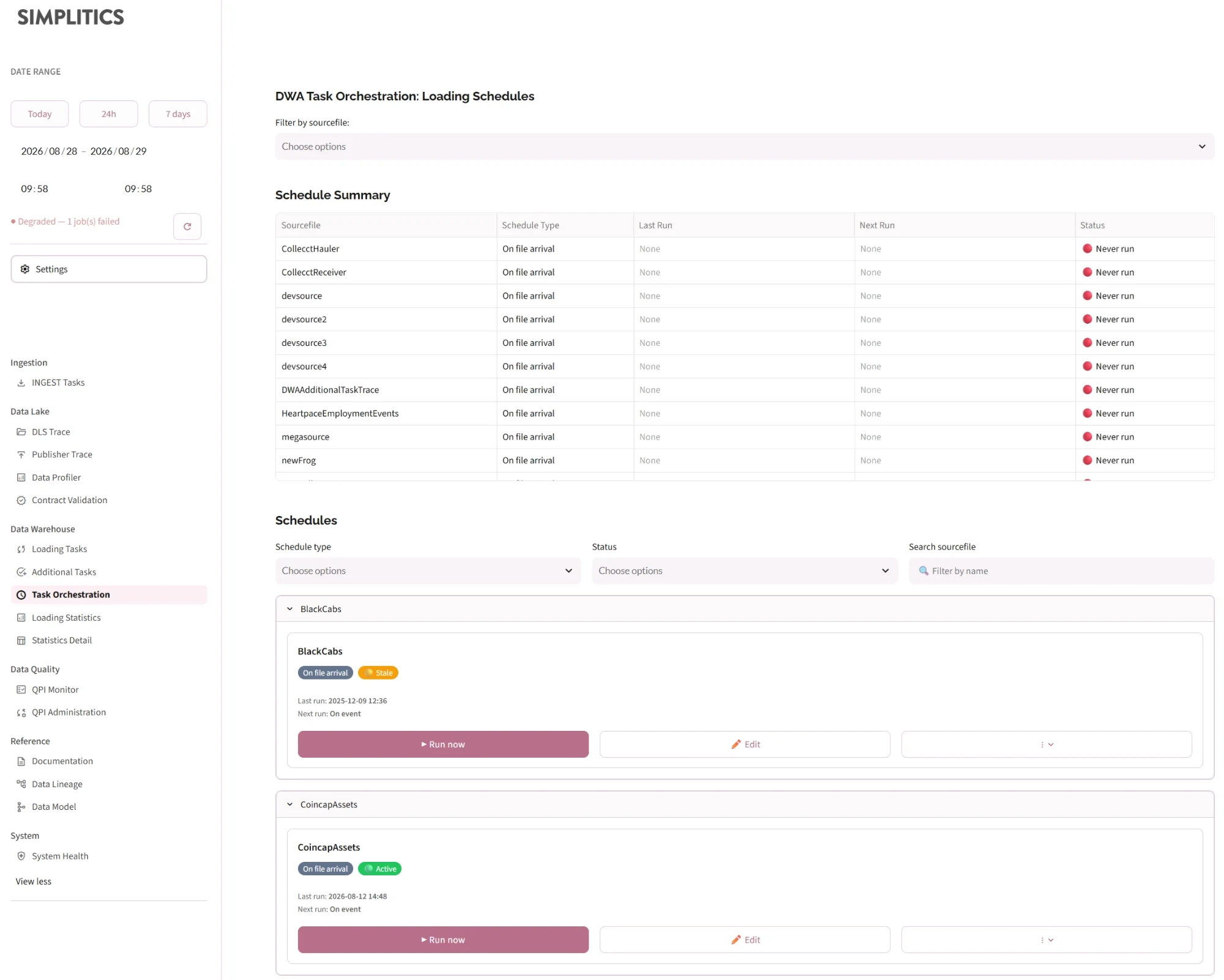

Task Orchestration: the schedule summary table and the per-sourcefile schedule cards with their Run now and Edit actions

Schedule Summary​

A sortable table of every sourcefile: schedule type, last run, next run, status — sorted oldest-run first, so anything neglected floats to the top.

Health status​

Evaluated per schedule, in order:

StatusRule
🔴 Never runNo last-run timestamp
🟡 StaleLast run more than 30 days ago
⚪ Config errorNot ad-hoc, but no next run computed
🟢 ActiveEverything else

Config error is the one to act on. A recurring schedule with no next execution will never fire again — it is broken, not idle.

Schedule cards​

Below the summary, one card per sourcefile, grouped into expanders by source-system prefix, with filters for schedule type, status and name. Each card shows the type badge (On file arrival, Hourly, Daily, Weekly, Monthly), the health badge, the interval, and last/next run.

Three actions per card, all admin-only and all confirmed inline:

ActionEffect
▶ Run nowTriggers a run immediately
✏️ EditOpens a form below the card row: schedule type, interval, earliest run time of day
⋮ → ⏹ DisableUnschedules the sourcefile by setting its validity to end now

Disable is tucked inside a popover specifically to prevent accidental clicks. All three are audit-logged.


Loading Statistics​

Volume analysis. Where the loading pages answer did it run, this answers how much did it move.

Sidebar filters — Sourcefile, Filekey, Object, Attribute — combine with the global date range, with an active-filter count and a Clear all filters button. The page auto-refreshes on the cache TTL and offers a manual Refresh.

Two tabs:

By sourcefile​

KPIs: sourcefiles, total stages, executions, rows loaded. Below them an interactive pivot table — choose your measures (insertCount, stageCount), with totals, subtotals and drill-down. The detail expander offers a CSV export and a selector that jumps straight to the detail page for one sourcefile.

By object​

KPIs: objects, unique sources, total rows inserted, executions, with its own pivot table pivoting on object, plus CSV export.

Statistics Detail​

The drill-down for a single sourcefile, reachable from the sourcefile tab or directly. Enter a sourcefile name (optionally an exact execution time) to get:

  • KPIs: executions, total stages, objects loaded, total rows inserted
  • Execution timeline — stages per execution over time
  • Rows inserted by object — stacked by attribute where available
  • Tables by sourcefile and by object, each with CSV export

A sourcefile whose row count drops sharply between executions, or whose stage count climbs while insert counts stay flat, shows up here long before it shows up as a failure anywhere else.
